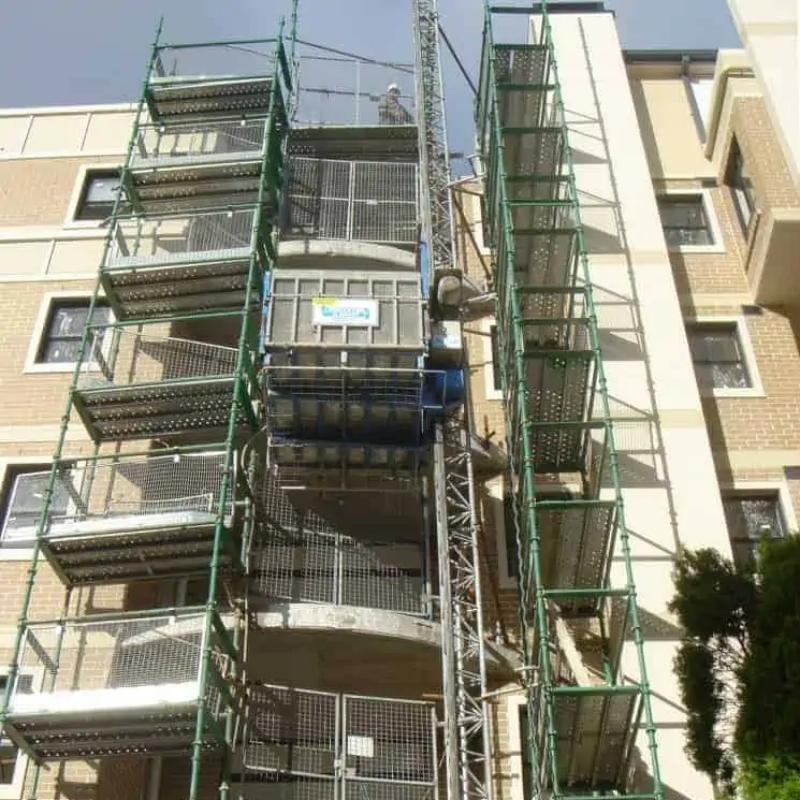

Why Hoist Size Matters

A material hoist that is too small forces crews to split loads, slows the build schedule and tempts operators to push past the safe working limit. Oversize the hoist, and you pay for capacity you will never use while chewing up scarce site footprint. The sweet spot sits in the middle, and getting there starts with an objective look at the job’s genuine lifting requirements.

Every project has a different mix of palletised products, long form steel, bulky joinery and loose tools. Weight is only part of the picture; deck length, door height, lift speed and cycle time all influence whether the gear you choose will keep up with the trade program. When builders across Australia need to balance those variables, they often begin by reviewing the material hoist hire options that cover their most common load cases first, then scale up or down for outliers.

Key Factors That Drive Capacity Needs

Project managers usually look at three data sets before they talk to a rental supplier: load profile, building geometry and logistical constraints. Understanding how those numbers interact prevents the nasty surprise of a mid-build hoist upgrade.

Deck dimensions
– Measure the longest and widest single item you expect to send up. Timber frames and pre-hung doors often dictate length, while plasterboard packs determine width. Add 10–15 per cent clearance so riggers can manoeuvre safely.

Static payload
– Sum the heaviest combined load likely to ride at once. In mid-rise residential, this is commonly a full pallet of bricks or a loaded wheelbarrow with reinforcement bar. Include pallets, stillages and lifting frames in the calculation; they are part of the live load.

Throughput rate
– A hoist running flat out for long shifts faces more wear than one used for periodic lifts. If you intend to move high volumes quickly, favour a unit with slightly higher capacity so the motor and brake assemblies work below their ceiling. The extra headroom preserves component life and minimises downtime.

Hook height
– Taller jobs put greater mechanical stress on drive gear and guide sections. Some compact hoists can carry a two-tonne load over a short mast but derate above 20 metres. Check the data sheet rather than assuming a “two-tonner” is two tonnes at every height.

Power supply
– Three-phase power handles heavier loads with smoother acceleration, while single-phase units suit light refurbishment work. Verify the available amperage at the switchboard early so electricians are not forced into last-minute upgrades.

Quick Ways to Estimate the Right Deck Size and Payload

Contract time rarely allows for lengthy engineering studies, yet a few back-of-envelope checks catch most sizing errors.

  1. Walk the lay-down area and note the five bulkiest items booked for delivery in the next six weeks.
  2. Photograph the delivery dockets or spec sheets for each item and record each item’s weight.
  3. Compare those dimensions against the internal platform size printed on the hoist’s technical brochure.
  4. Confirm that the aggregate weight of any likely combination remains 10 per cent under the rated capacity.
  5. Factor in weather allowances if wind can funnel through the structure – gust loads add unexpected force.

If the numbers are close to the limit, move up one model. The cost delta between neighbouring sizes is usually smaller than the expense of an on-site stand-down when inspectors red-tag an overloaded cage.

A real-world example: a four-storey childcare redevelopment in Melbourne needed to lift 3.6 m laminated beams weighing 420 kg each. A 900 kg hoist looked adequate until installers realised two beams plus a trolley breached capacity. Bumping to a 1,500 kg unit kept the programme intact and only added a marginal daily rate. It also demonstrates how material hoists help reduce manual handling injuries by reducing the need for workers to lift, carry and reposition heavy construction materials repeatedly.

Matching Hoist Features to Australian Site Conditions

Climate, codes and urban density all shape the final selection.

Wind regions
Northern coastal sites fall under Region C of AS/NZS 1170.2, triggering stricter tie-in spacing and derating for exposed masts. Check that the hoist manufacturer publishes load charts for cyclonic areas; not all European imports do.

Urban footprint
Inner-city lots leave little room for ground-level loading pens. Compact base frames and side-gated platforms allow you to position the hoist tight against party walls without obstructing footpaths. A sliding roof canopy prevents debris from dropping onto pedestrians while still providing crane access for large items.

National Construction Code updates
The 2022 NCC revision clarified responsibilities for barrier heights and door interlocks on temporary lifting equipment. Choosing a unit that already meets the new clauses avoids retrofitting safety hardware mid-hire.

Regional power quality
Rural feeders can suffer voltage dips during harvest and irrigation seasons. Variable frequency drives (VFDs) smooth start-up current draw, reducing nuisance trips. Ask the supplier for models with inbuilt VFDs if your project sits on a long SWER line.

Final Checks Before Locking in Your Hire

Before you sign the agreement, run through a short verification process that combines paperwork with a quick site walk.

Confirm test certificates
Request the current major inspection report and evidence of Load Block Test compliance. Certificates should match the exact serial number of the hoist being dispatched, not an identical fleet sister.

Inspect anchor points
Mark the proposed mast tie locations on the slab or scaffold. Engineers may require supplementary brackets or chemical anchors if the default pattern clashes with façade set-outs.

Verify training coverage
Most states accept a WP High Risk Work licence for materials hoists up to prescribed capacities, but New South Wales additionally mandates familiarisation by a competent person. Plan the toolbox session before the hoist arrives so crews can lift legally from day one.

Book preventive maintenance
Agree on intervals for greasing, rope inspections and limit switch testing. A short scheduled pause every fortnight beats an unplanned breakdown during the concrete pour.

Cross-check legislative guidance
Safe Work Australia’s model Code of Practice for managing plant at the workplace explains duty holder responsibilities for inspections, logbooks and emergency procedures. Reviewing the relevant sections at Safe Work Australia alongside the hire contract ensures no compliance gap slips through.

Selecting the correct material hoist size is less about picking the biggest unit on the rate card and more about matching real site demands with documented performance limits. A methodical review of load profiles, building geometry and local regulations removes uncertainty and keeps lifting operations both efficient and safe.
